Msgr. Marcaccio, Parish Commission Chair Dick Pauley, and Building Chair Tom Martin check out the girders after their arrival. Fortunately they didn't have to do anything but watch.
Sunday, May 31, 2009
AN EARLY MORNING DELIVERY
Monday, May 25, 2009
More Steel on the Way!!
Happy Memorial Day! There was no activity on our church today, but that all changes tomorrow. The last 2 weeks have provided us with the framework for the Narthex and Day Chapel as well as the floor and decking for the Narthex. Tomorrow, a larger crane which you may have seen this weekend will be setup and ready for the first truck to arrive with the steel for the Main Nave.
These Photos show the results of the last week. With luck from the weather
Sunday, May 17, 2009
Steeling ourselves

If you've driven past our construction site on North Elm this week, you've seen how our new church is really starting to take shape.
Williams Steel, a Greensboro firm located on South Elm-Eugene Street has been working to fabricate all the steel we'll need for"Making a Place at the Table".

The company loaded up six trucks and started bringing it all 200 pieces of steel over, piece by piece on Monday, May 11th.

As the workers unloaded the steel beams, they laid them out across the site in preparation for construction -- which would start the same day. By Monday afternoon, many of the uprights were already in place.

This week, work has been done in the narthex, the chorus practice room/family room, bathrooms, the side wall opposite Elm Street and the day Cchapel. Currently the basement is 80% completed.
The outline is emerging:


This week workers will continue to use the steel onsite so watch for more growth and changes as the narthex and day chapel will be framed in steel. The concrete floor of the narthex will be poured and the crane repositioned for the rest of the steel to come.
Phase II of our steel work is expected to begin May 26th when the next round of steel comes. That work will include the sanctuary. Also in late May or early June, the two largest beams which form the center nave will be delivered. These beams each weigh 9 tons and are 70 feet long. Here's one of them, from a photo taken at Williams Steel.

Special thanks to Tom Martin for his photos, timeline and construction tidbits.
Friday, May 8, 2009
A Construction Tail
When Saint Pius X Church started "Making a Place at the Table" for all in our parish, we never expected to have this unusual family take us up on the offer.
A feral cat who has long visited our church grounds, created her own "Place at the Table" when she delivered five kittens behind an AC unit beside the Kloster Center. When workers lifted that unit this week, they found the three-week old kittens huddled together.
The workers used materials at hand to keep the kittens safe, while calling the church office with the news.


Teresa Marie Vestal and Jeanine Lazusky grabbed a mail carrier box and a towel to collect the kittens: three boys and two girls, all in great health. You can see how cute they are in these photos. All together, there were two calico females, two orange males and one black male with white paws.
Just look at those faces! Teresa and Janine spent about an hour with them, showing them to the Saint Pius X school office staff. That's when first grade assistant Mrs. Holly Fortun called her neighbor, Cynthia Johnson, who quickly came over to bottle feed the new kittens. Not only did she feed them lunch that day, but she also made arrangements to have the kittens receive their first shots, get dewormed and even found a home for one of the orange males.
Monsignor's veterinarian, Dr. Tina, took on the kittens as new patients and cleared them to be placed in homes once they can eat on their own.
Meantime, we're so grateful to Cynthia Johnson for her time and effort to keep our new parish pets healthy until their adoption days come.
One of our parishioners, Peggy Delisi, has tried to catch the feral mom for several years, and owns several kittens from the mama cat's previous litters. The Feral Cat Society has been called, and together we're trying to ensure the mama cat is spayed and then released.
After the kittens' nine lives were spared, construction workers resumed their installation of the new AC units behind the Kloster Center.
Special thanks to Teresa Marie Vestal and Tom Martin for their pictures and accounts of the kittens' tail ... I mean tale.
*** Edited to add update.
If you'd like to adopt one of these kittens when they are old enough, please contact Teresa Marie Vestal. You can email her at teresamarievestal (at) gmail (dot) com.
And I am deliberately spelling out her email address so she is not added to many, many email lists by robot spammers. You would write it in the usual way when you send the email, though.
A feral cat who has long visited our church grounds, created her own "Place at the Table" when she delivered five kittens behind an AC unit beside the Kloster Center. When workers lifted that unit this week, they found the three-week old kittens huddled together.

The workers used materials at hand to keep the kittens safe, while calling the church office with the news.


Teresa Marie Vestal and Jeanine Lazusky grabbed a mail carrier box and a towel to collect the kittens: three boys and two girls, all in great health. You can see how cute they are in these photos. All together, there were two calico females, two orange males and one black male with white paws.

Monsignor's veterinarian, Dr. Tina, took on the kittens as new patients and cleared them to be placed in homes once they can eat on their own.
Meantime, we're so grateful to Cynthia Johnson for her time and effort to keep our new parish pets healthy until their adoption days come.
One of our parishioners, Peggy Delisi, has tried to catch the feral mom for several years, and owns several kittens from the mama cat's previous litters. The Feral Cat Society has been called, and together we're trying to ensure the mama cat is spayed and then released.
After the kittens' nine lives were spared, construction workers resumed their installation of the new AC units behind the Kloster Center.
Special thanks to Teresa Marie Vestal and Tom Martin for their pictures and accounts of the kittens' tail ... I mean tale.
*** Edited to add update.
If you'd like to adopt one of these kittens when they are old enough, please contact Teresa Marie Vestal. You can email her at teresamarievestal (at) gmail (dot) com.
And I am deliberately spelling out her email address so she is not added to many, many email lists by robot spammers. You would write it in the usual way when you send the email, though.
Sunday, May 3, 2009
BUILDING A STRONG FOUNDATION
Today at mass, the Responsorial Psalm was "The stone rejected by the builders has become the cornerstone". Well, we're working on getting the cornerstone for our new church home, but first we must build a strong foundation. Building the foundation is a slow process, but a critical one. Since, most of the work to build the foundation is out of sight, I thought this would be a good time to show you what's been happening.


First, the surveyor gives the workers points that they use for measurements. They then put markings on the dirt where the column lines and footings must be placed. After this meticulous task, the workers get a backhoe and begin digging out the area.

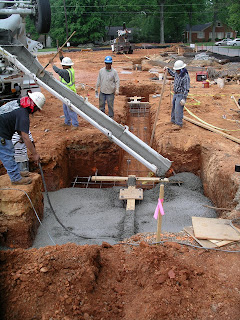

After the trenches are dug, rebar or a reinforcing bar (a common steel bar used in reinforced concrete) is placed in the holes that have been dug. In addition, plates are installed that will be used to mount the steel beams. Once this is completed, the City inspected the work and then concrete is poured.

Once the concrete dries, the finished foundation is ready for placement of the steel beams. Depending on the size of steel that will be placed, each footing is approximately 4 feet square and 3 feet deep.

First, the surveyor gives the workers points that they use for measurements. They then put markings on the dirt where the column lines and footings must be placed. After this meticulous task, the workers get a backhoe and begin digging out the area.
After the trenches are dug, rebar or a reinforcing bar (a common steel bar used in reinforced concrete) is placed in the holes that have been dug. In addition, plates are installed that will be used to mount the steel beams. Once this is completed, the City inspected the work and then concrete is poured.
Once the concrete dries, the finished foundation is ready for placement of the steel beams. Depending on the size of steel that will be placed, each footing is approximately 4 feet square and 3 feet deep.
